How a Fibreglass Pool Is Installed: Steps & Timeline
Every step of fibreglass pool installation — site visit to first swim in 10–12 weeks, 28 days on site. From a Brisbane installer's build sheet.
Published

A fibreglass pool arrives at your home as a single factory-moulded shell, and fibreglass pool installation (fiberglass, in the US spelling) is the work of putting that shell in the ground and finishing a swimming pool around it. The sequence: excavate a hole matching the shell's exact dimensions, screed a level base, crane the shell into position, connect the plumbing, filtration and electrical, backfill against the walls as the pool fills, then pour the concrete surround and lay the coping and paving. The shell goes in — and holds water — on the same day the hole is dug. Across Brisbane and South East Queensland the full build runs 10–12 weeks from first contact to swimming, with about 28 days of on-site construction inside that; the rest is design, contract and council-approval time. The pool itself was built in a factory, which is why the work in your yard is measured in weeks.
How is a fibreglass pool installed? The steps before the dig
Most of a fibreglass pool installation happens before an excavator ever reaches the yard: a site visit, a 3D design, a contract, council approval and a pre-start walk-through, in that order.
The site visit is free and takes one to two hours. The yard is measured, access is assessed — where a crane can set up, which path the shell will travel in over the house or the fence, what a truck can actually reach — and the soil is inspected, because the ground decides how the dig behaves. Pricing happens on the spot, before the visit ends.
Before any commitment, the design goes into a 3D render: the pool modelled in your actual backyard, so model, position and size are decided looking at your own yard.
A contract follows, and it names five things: the pool model, the colour, the inclusions, the timeline and the price. The model comes out of the fibreglass pool models range — the contract ties one specific shell, at one specific finished price, to your site.
Council approval is handled by the installer, not the homeowner: DA/CDC applications, engineering certificates, barrier compliance under the pool fence regulations in Queensland, and the back-and-forth with council itself. Approvals take two to four weeks, and you receive copies of every document lodged.
The final step before excavation is the one most pool builders skip: a pre-start site visit of 1.5 to 2 hours with the Construction Manager who runs the build. Machine access, shell position, equipment position and finished levels are confirmed standing on the site, before the excavation and the crane are booked. That confirmation is what keeps a build on schedule — an access problem or a level question found at pre-start is resolved before machinery is committed to a date, instead of on installation day with contractors on site.
What happens on installation day?
On installation day the hole is dug, a level base is screeded into it, the shell is craned into position, the plumbing, filtration and electrical are connected, and water goes into the pool — all in the same day.
Site preparation and excavation set the quality of everything that follows, and the dig runs to a dig sheet: the shell's exact length, width and depth profile plus working clearance — not an inch more. A licensed excavation team digs to that specification.
The base comes next: a screeded, level bed across the floor of the hole for the shell to sit on. Level is confirmed again once the shell is placed, because the time to correct it is before any backfill goes in.

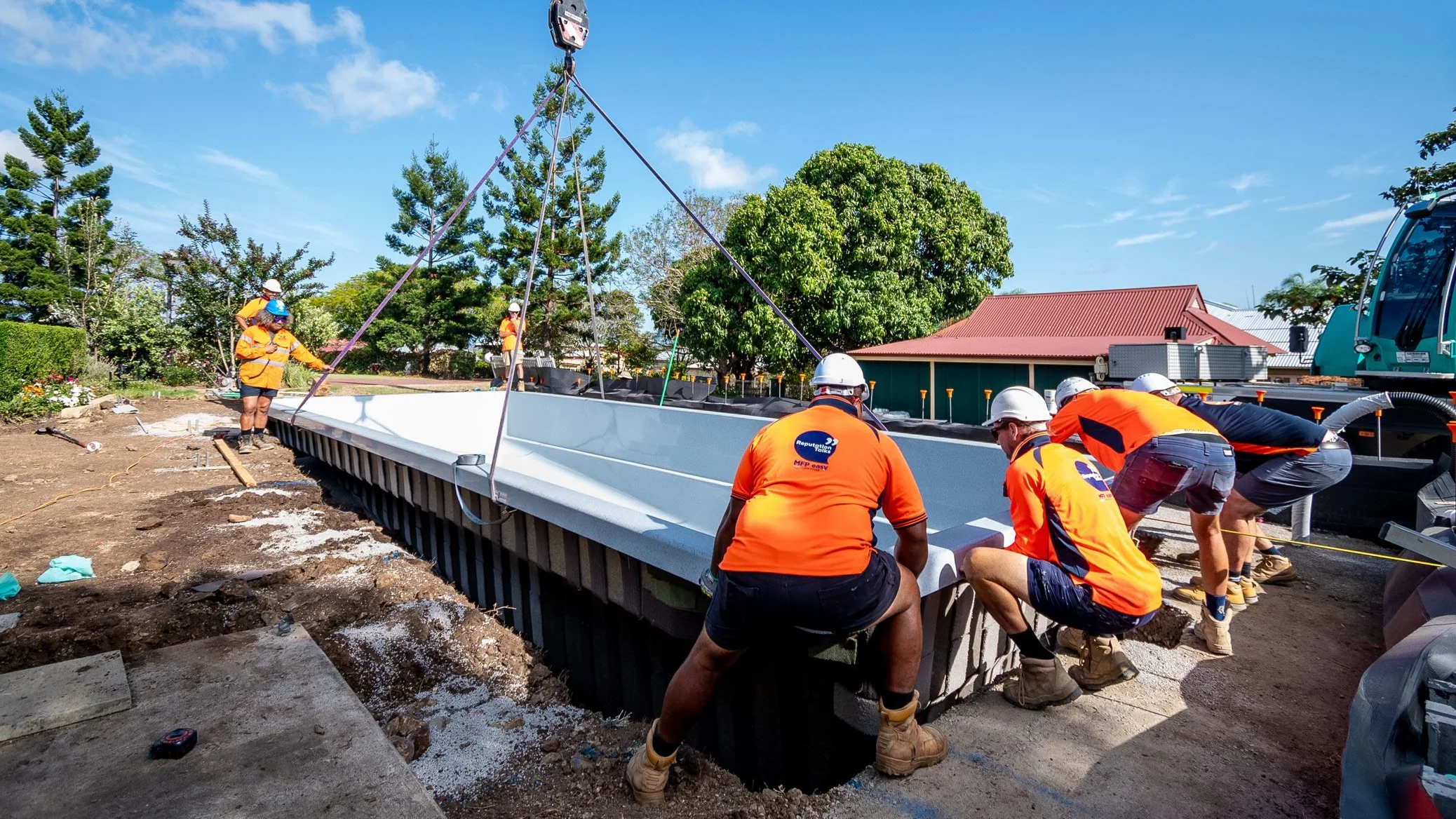

The shell itself is an Aqua Technics pool, factory-built with Graphene Nano-Tech in the laminate, and it arrives on a truck in one piece. It goes into the hole by crane — over the house or the fence when that is the only path — or, where access allows, on the excavator that dug the hole. Either way, the lift and set happen inside a single day.
With the shell sitting level, the plumbing and filtration lines are run and connected, and the electrical is hooked up.
Water goes into the pool the same day.
How long does a fibreglass pool installation take?
A fibreglass pool installation takes 10 to 12 weeks from first contact to swimming, with about 28 days of on-site construction inside that span.
| Weeks | Stage | What happens |
|---|---|---|
| 1–2 | Design and 3D render | Free 1–2 hour site visit; yard measured, access and soil assessed; price given on the spot; pool rendered in your backyard |
| 2–6 | Council approvals | DA/CDC applications, engineering certificates, barrier compliance — all handled by the installer |
| 6–8 | Pre-start and scheduling | 1.5–2 hour pre-start visit with the Construction Manager; excavation and crane booked |
| 8–9 | Excavation and installation day | Dig to the dig sheet, screeded base, shell craned in, plumbing and electrical connected, water in the pool |
| 9–10 | Concrete and paving | Concrete surround poured, coping and paving laid |
| 10–11 | Handover and Pool School | Final clean, equipment and water chemistry walkthrough, first swim |
Construction itself is roughly four weeks — 28 days on site, and that figure is a firm commitment rather than an estimate. The longer stretch of the calendar sits before the dig: signed contract to excavation averages six to eight weeks, most of it council approval and scheduling. Design takes one to two weeks; approvals take two to four.
The 10–12 week span is set by approvals and scheduling, not by construction. The parts a homeowner pictures — machines, crane, concrete — are the short half of the project; the paperwork half runs longer and runs first.
Can you install a fibreglass pool yourself?
Yes — fibreglass pool shells are sold as DIY kits in Australia, and a kit is the shell only. A turnkey installation covers the shell plus excavation, crane hire, licensed plumbing, licensed electrical work including equipotential bonding, engineering sign-off, council approval and the concrete surround; a DIY builder buys every one of those separately, from licensed trades where the law requires it.
That same list answers the DIY cost question. A kit price pays for one component; an installed price pays for the finished pool. The gap between the two numbers is excavation, a crane, a plumber, an electrician, an engineer, council approval and concrete.
| DIY kit purchase | Turnkey installation | |
|---|---|---|
| Fibreglass shell | Included | Included |
| Excavation | Contracted separately | Included |
| Crane hire | Contracted separately | Included |
| Plumbing | Licensed plumber, engaged separately | Included |
| Electrical + equipotential bonding | Licensed electrician, engaged separately | Included |
| Engineering sign-off | Owner arranges | Included |
| Council approval + barrier compliance | Owner arranges | Handled by the installer |
| Concrete surround | Contracted separately | Included |
Queensland does not lighten the rules for owner-builders. Council approval, engineering certification and pool barrier compliance apply to a DIY fibreglass pool exactly as they apply to a professional installation, and the plumbing and electrical connections are licensed trades regardless of who manages the project.
The difficulty concentrates in precision and sequence: an excavation that matches the shell, a base screeded dead level, a crane lift with clear access, services connected and certified. A professional crew runs that as one planned day. An owner-builder specifies, schedules and verifies each piece across separate subcontractors — the work is the same; the coordination burden moves to you.
What surrounds the shell: coping, paving and backfill
Coping is the hard edge that caps the rim of a fibreglass pool shell. A fibreglass pool does need it: the shell finishes in a lip at the top, and coping covers that lip and joins the pool to the paving around it.
The common coping materials are poured concrete, natural stone pavers and concrete pavers, with timber or composite decking boards doing the same job where a deck runs to the water. Pavers cut for coping carry a bullnose or drop-face profile, so the edge that meets the water is finished rather than raw. The best material is the one that matches the rest of the surround — pavers give a defined, individually replaceable edge; poured concrete gives one continuous surface; decking suits a pool set against an entertaining area — and the choice between pool decking or paving shapes the whole outdoor area, not just the pool edge.
On our builds, Category 1 stone pavers are the standard inclusion, with a second row of paving added at the deep end.
Below the paving, backfill does structural work. A fibreglass shell is supported by loads on both faces — water pushing out, backfill pushing in — which is why the pool is filled with water while backfill is placed around the walls: the two pressures rise together and the walls stay evenly loaded. Backfill is part of the pool's structure, not landscaping.
What can go wrong with a fibreglass pool installation?
The faults that appear in fibreglass pool installations trace to a short list — electrical scope, bonding, equipment placement, base quality, shell level, buried plumbing and backfill — and each one is preventable during the build.
Some pool contracts exclude the electrical hook-up altogether, which surfaces as a separate electrician's bill after the pool is otherwise complete. A complete contract names the electrical connection in its inclusions; the time to look for that line is before signing.
Equipotential bonding — connecting the metal components around a pool so no voltage difference can exist between them — is licensed electrical work that disappears from view once the paving goes down, and it is verified by certificate. A properly run build has the electrician bond and certify as part of the electrical scope.
Equipment placement matters because it is permanent: a filtration pad set hard against the house puts pump noise beside a window for the life of the pool. Placement is fixed at the pre-start visit, while moving it still costs nothing.
Base quality decides whether the shell stays level. A base screeded from poor material, or left uncompacted, can settle under the shell — and an out-of-level shell shows at the waterline permanently. The control is sequencing: the shell is levelled in the hole and confirmed before any backfill is placed, because level cannot be corrected afterwards.
Plumbing runs are buried under backfill and concrete, so an under-slab leak found after handover means cutting into the finished surround to reach it. The prevention is cheap and early: the pipework is tested under pressure before anything is buried, while every joint is still reachable.
Poor backfilling is the mechanism behind fibreglass pool wall bulging: backfill placed badly, or without water in the pool to balance it, presses the walls inward. Placed progressively against a filling pool, the same material holds the walls straight.
What does a fibreglass pool installation cost?
A professionally installed fibreglass pool is quoted as one turnkey figure — shell, excavation, crane, filtration, approvals and paving in a single number. These are the current installed price bands by pool category:
| Pool size | Length | Depth | Installed from |
|---|---|---|---|
| Round pools | 3m to 4m | 1.45m level | $44,805 |
| Small pools | 4m to 5.5m | 1.0m to 1.78m | $53,157 |
| Medium pools | 6m to 7m | 1.0m to 1.88m | $57,540 |
| Large pools | 7.2m to 8m | 0.98m to 1.96m | $60,894 |
| Lap pools | 8.25m to 11m | 0.9m to 2.0m | $65,953 |
Live all-inclusive installed pricing for standard site conditions in South East Queensland — updated straight from our quoting system.
Fibreglass pool installation costs move with the site: access, slope, soil and what already occupies the yard all act on the final figure. The pool pricing quiz turns those site factors into an installed price band for your specific block.
The installation process with MFP Easy runs the same way on every build: weekly updates from a named contact, two cleans during construction and one at handover, a Pool School session at handover covering equipment, water chemistry and maintenance, and a service check-in at 30 days.
FAQs
Does a fibreglass pool have to be in the ground?
No. Fully inground is the standard installation, but a fibreglass shell can be installed semi-inground — partly raised out of the ground, as on a sloping block — with engineering to support the exposed walls. The engineering certification that every pool installation needs simply covers the raised design as well, and Queensland pool barrier rules apply at any installation height.
How fast can a fibreglass pool be installed?
The shell can be in the ground and holding water on the same day the hole is dug — that is the standard installation day, not a special effort. The calendar around it is what takes the time: council approval runs two to four weeks, pre-start and scheduling follow, and concrete and paving come after the shell. First contact to swimming is 10 to 12 weeks, with about 28 days on site.
Is it difficult to install a fibreglass pool?
The difficulty is precision and coordination rather than any single task. The excavation must match the shell's dimensions, the base must be screeded dead level, the crane lift needs clear access, and the plumbing and electrical connections are licensed trades. A professional crew does all of this as one planned day; an owner-builder must specify, schedule and verify each piece separately across multiple subcontractors.
What are common problems with fibreglass pools?
The installation-caused problems are a shell set out of level, wall bulging from poorly placed backfill, leaks in underground plumbing runs, and missed equipotential bonding. Each has a build-time prevention: the shell levelled and confirmed before backfill, backfill placed progressively against a filling pool, pipework tested before it is buried, and a licensed electrician's bonding certificate for the metal components around the pool.
